Straws are discrete research notes that relate to a particular aspect of the company. Grouped under #hashtags, they are ranked by votes.
A good Straw offers a clear and concise perspective on the company and its prospects.
Please visit the forums tab for general discussion.
https://wcsecure.weblink.com.au/pdf/ARU/02926853.pdf
My thoughts:
I'm super pumped for this. This is my largest holding ever. It has been a difficult hold. But as they say in mining, Finance It And They Will Come. Do they say that?
I can see the SP moving up with every annoucment now. There has been movement up in the last week. So we have a leaky ship. With so many particpants in this deal...always likely to be some leakage.
TIme to jump on the ARU rare earth rocket ship!
That being said....i would imagine the SP will only go to about 30-40 cents in the short term.
But as said in previous posts....lots of other macro issues will push this higher int he medium term too:
Ask any questions you want. I'm happy to answer these.
Feels like news is coming. Some green with the SP of late.....
To meet the CEO's stated time frames (FID by end of June 2025), we would be expecting the cornerstone equity to be announced in the next few weeks, along with the off take.
I think that should then see the SP move substainally up....
Geeze these mega finance deals take forever!!!! Come on!!
So i have been playing around with some numbers. Was trying to work out how much Hancock can put in and not breach the 19.9% level.
HP currently owns 10.01% of ARU representing about 240 million shares. Post raise, if she wants to increase this to 19.9% she would want to own about 1.2 billion shares (based on a 30 cent raise and total 6 billion of shares). So she needs to buy about 960 million shares. So at 30 cents per share that is $288 million. Obviously she may not want to put that much in….but that is the max (at this stage…keep an eye out for creep (3% every 6 months is allowed)). Also I did not look at her daughter. Didn’t she buy into Arafura? I have assumed that is part of the current 10.01%.
Then I saw this video:
https://www.youtube.com/watch?v=WiF7hpdHHNo
So in this video of DC with Proactive Investors, at the 4:04 mark….DC said that ‘cornerstone equity’ will make up 60% of the equity. Previously this has been 50%. So this is great news. He then went on to say it could be 50-60%. We obviously have some competition from the cornerstones to jump on board the ARU equity train. And that is why he was saying 50-60% for the cornerstone equity. Also...it could change because of the raise price and Gina/HP wanting to maintain their 19.9% stake.
So ARU are raising AUS $1.2 billion in equity. So 60% is $720 million.
So I think the equity stack looks something like this:
- Cornerstone 1 - Hancock Prospecting* - $288m (this could be less if raise is below 30 cents. See my calc below)
- Cornerstone 1 - Posco - $250m
- Cornerstone 2 - Australian Government - $200m (Announced)
- Institutional 3 - Australian Super - $100m
- Institutional 3 - FUND A - $100m
- Institutional 3 - FUND B - $100m
- Exisiting Shareholders 4 - Retail via SPP - $200m
And remember that the ARU CFO Peter S said that they have lots of parties for each of the slices of equity. This gives us (some) confidense in the likely raise price.
Things are slowly progressing.
I would also note that from a macro perspective, things are always improving for us (being ex-china supply):
I have gone back and tested all the assumptions based on the last year or so of updates. Usual caveats….DYOR…I may have modelling errors…etc.
My key takeaway….ARU is not priced correctly at its current 13 cents. Maybe this is the market’s discount for not being fully funded yet and/or bit of market manipulation.

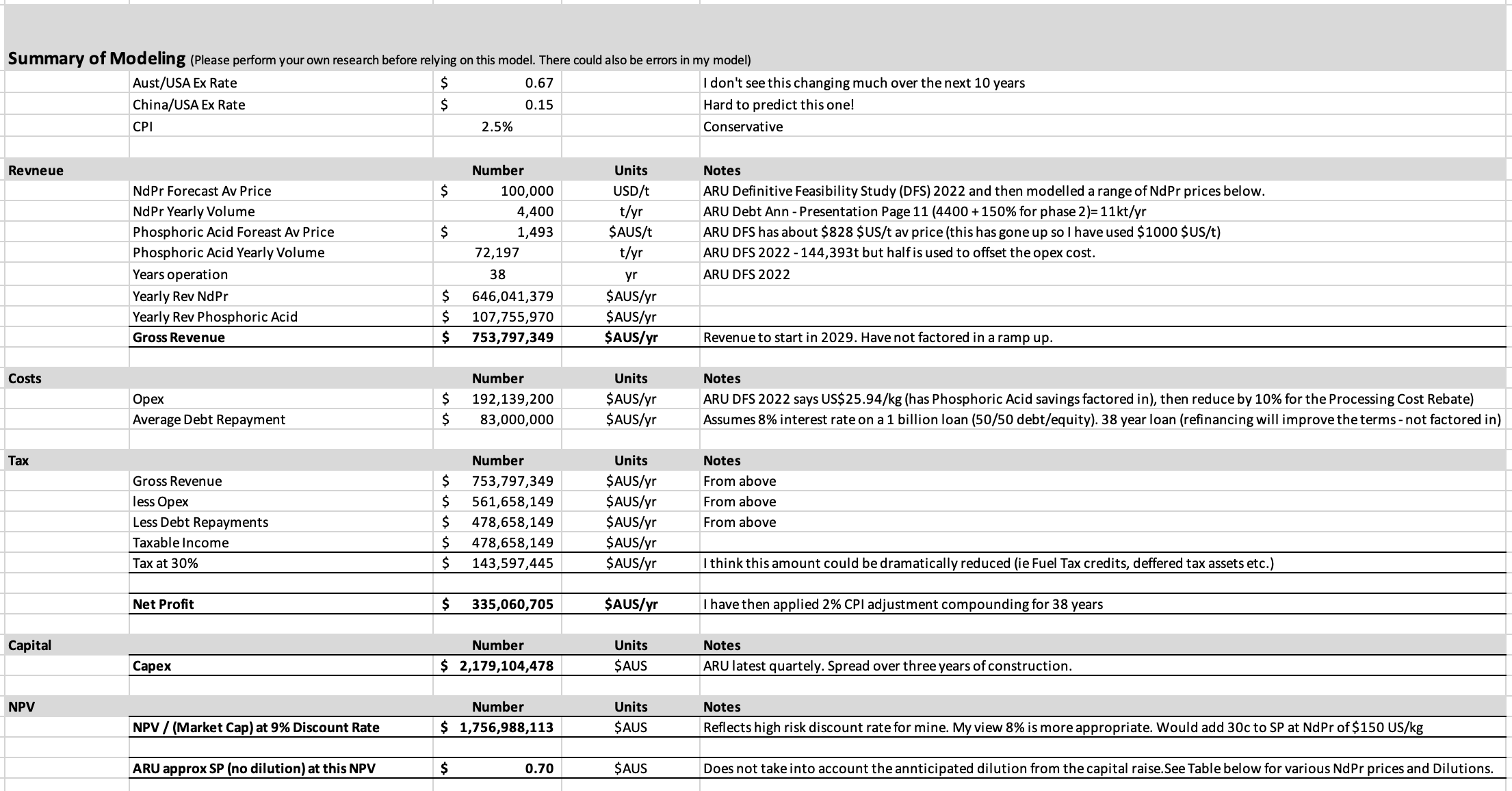

Here are the assumptions used in my model:
Here are the results of different NdPr prices and dilutions for Phase 1 (4,400) and Phase 2 (11,000).
Some points to make:
1 - Diluted to the Max - If ARU management had of raised when the SP was $0.70, exisiting shareholders would have been MASSIVELY in a better position than we are today. I think this borders on negligence because the board knew that ECE Nolans were going to sell on the market (creating downward momentum), short position was clearly going up, they knew the timelines of the finance etc. etc. It looks like we will be adding about 3-7 billion new shares to lock in the Final Equity Raise.
2 - Phase 2 is where it is at - It is clear we have a ‘gold plated’ project here. The cost is massive and we have contingency upon contingency. I understand that to reach finance on what the market perceives to be a risky project, they required all this gold plating and contingencies. But if management are up to the task, and can deliver Nolans and barely touch these contingencies, then combined with some of the first year ‘profits’ Phase 2 should be able to be built without raising more capital. If management can achieve that, I may forgive them for the failure in point 1 above. And this also does not factor in additional supply from other sources. So these SP’s are a lower bound.
3 - NdPr pricing is sensitive - Given everything that is going on with Trump and the rest of the world, NdPr pricing should go up, but by how much. My previous ex-china supply deficit modelling showed massive demand from 2026. This is a hard one to predict. But you want some skin in the ex-china NdPr game…..because the modelling shows the valuation is very sensitive to it.
4 - There is still value left!!! - From today's SP of 13 cents.....upon FID...my most likely scenario (in Yellow Box) will x2 your money. If you wait for Phase 2 (in Orange Box) (probably in around 2-3 years) will x7 your money. (obviously lots and lots of assumptions etc. etc.)
The analysis above is just looking at fair value using Net Present Valuation method. If the market was rational, it would be priced somewhere close to the above prices.
But there are some other tail winds that may cause SP to go up even more than the above:
- There will be a bunch of funds that were involved with the equity raise, that missed out, and would likely buy on the market (ie they have done the due diligence…and know what a great project it will be and happy to buy in a little above - or at least will provide a back stop if it drops).
- There will be lots of funds, institutions, family offices and retail that will not invest in a mine until it is fully funded.
- All the tariff talk is not only getting stronger, it is happening. This will be a wake up call to China and the west. None of this is factored into our SP.
- Once ARU achieve FID, watch all the other NdPr juniors out there contact ARU management to discuss processing. Expect lots of announcements around this.
- Also watch the phosphoric acid, and if we lock in much better terms due to ARU being pretty much the only unassigned ex China product!
Once FID is achieved, ARU will be the first NdPr mine (at scale) to begin construction since Lynas around 2010. That is 15 years ago. Back in 2010, NdPr demand was about 30,000 tpa. Today it is about 75,000 tpa and expected to double to about 150,000 tpa by 2035. ARU in phase one is only producing 4,400 tpa. Where is all the ex-china supply going to come from?
So if you want a quick buck i think it will be $0.25-0.35 upon FID (around June/July 2025).
If you wait for Phase 2 (i think the market should start to factor this in around mid 2026) the value is about $1.00.
See my post for the NPV modelling etc.
My notes from the Quarterly for period ending 31 Dec 2024.
Held via webcast on 30 January 2025.
Summary:
CEO Intro
- ARU will be a great counter cyclical investment (ie production timed perfect for Supply deficit for ex-china NdPr)
- NRFC were confident in their investment with lots of DD. But took time because ARU had to match and not conflict with debt and shareholder interests.
- Supply - ARU the only ore to oxide to move into construction in the near term. Structural supply deficit coming.
- Off take - expect soon large off take linked to equity. 2-1 (ie double the demand for ARU supply).
- Costs - running better than forecast (with cash ok for runway).
- Read to rock (and roll) upon FID
- Market conditions - NdPr pricing hitting ‘firmness’….investors need to distinguish between short term and medium term pricing. China lost money by suppressing prices….doubling of demand over next decade, ex-china market being formed, tariffs…….ARGUS Media are modelling that NdPr needs to increase 2-3 times from what we have today.
Question - Ex-China NdPr Market? People talking about ex-china NdPr market being formed. Doubters always talk about Lynas low offtake rates and ARU/ILU with no off take locked in. Assume tier one players out there want to lock off take for all the geopolitical reasons. But won’t lock in until FID to maintain their relationships with China. Modelling shows a supply deficit. Why has the market not responded accordingly?
Answer - CEO
- When negotiating with tier 1 they value security of supply (ie Av EV is $53k and NdPr is $55). They see this playing out in discussions (EV and Turbines) AND HAVE FLOORS IN THESE CONTRACTS ABOVE CURRENT NDPR PRICES. [Cop that! Wow. Best part of the discussion]
- In terms of market dynamics, they said there will be a structural deficit, so supply security will be first and foremost in companies minds. Last time this happened, the market went up to $200+ for NdPr. So likely to see spikes.
- As a sector there will be a move to create an ex-china price index…they are talking to a forecaster willing to establish this index…ARU need to put volumes….ARU can do this by using the 20% of Phase 1 remaining. [I assume other ex-china will put on there as well and create this market]
Question - ARU Phase 2 - Will Phase 2 be funded from savings from Phase 1….and profits in the early years. No need to return to the market? Ie no more capital raises to fund Phase 2?
Answer - CEO
- Intention to fund phase 2 out of phase 1
- Don’t foresee raising further equity
- learn from phase 1 to make phase 2 capex/opex cheaper.
- Phase 2 will become a processing hub….bring in from other projects external to ARU….will unlock Australian rare earth sector providing an avenue for processing away from china.
Question - No change in off take negotiations in last 18 months
Answer - CEO
- Hyundai/Kia. Locked in. [They must of renegotiated the CP dates?] So this is good news.
- ARU are using remaining off take volumes to bring in equity.
- Expect any future announcements to have off take and equity linked.
Questions - Trump policies etc.
Answer - CEO
- Support for EV in USA…only 12% global sales…..not worried about impact on ARU. If read executive orders….they refer to rare earth diversification and security. Will be good for sector…and very good for ARU….we are ore to oxide (processing ex-china)…..most others depend on china….Also ARU are construction ready…other rare earth mines have some time to go.
- Greenland….average time to find ore to production is 18 years……ARU positioned well. Most rare earth mines are only early stage…..so long time to go for them.
Question - timing on construction
Answer - CFO
- Still targeting FID end of the first half of 2025. These off take/cornerstone investors have their own processes and DD. ARU responsive…to help their processes. He did note that these off take/cornerstone investors have their own pressure to lock in supply…they see the supply deficit coming.
Question - EV slowdown in Europe?
Answer - CEO
- ARU not worried….look at medium term….when ARU will be producing. There will be blips along the way to EV growth.
- Compare EV to conventional. EV costs coming down. Charging infra filling out. Solid state batteries have fast charge and range. All points to increase in EV uptake. Demand doubling over next decade. Other companies say more.
Question - Will ARU consider a move downstream further from oxide (ie to metal)
Answer - CEO
- ARU already doing 95% of the value chain to a metal (ie ore to oxide)
- ARU don’t see the return is worth it. And Ex-china strategy means we don’t need to.
Question - Sulphuric Acid
Answer - CEO
- Not currently under binding off take
- Confirmed it will be better than merchant grade acid (MGA)
- Confirmed the ARU economic model sold at MGA prices
- ARU will look for customers of the MGA who can take it to battery grade….maybe.
- BUT MGA is very good anyway.
Question - Equity - Are we speaking to multiple cornerstone or are we at preferred stage?
Answer - CFO
- Still talking to multipole players…and have redundancies.
- Well above 50% for cornerstone equity…..
- The Debt and off take has focused on Korean businesses…..and likely to be similar for equity side as well.
Question - Are GE still in the game
Answer - CFO
- Hyundai are a key off take party….they might do equity…..ARU and Hyundai have an MOU around equity…not yet binding….ARU still see them as a target.
- It has been hard for some of these off take parties to invest in ARU because they don’t tend to invest at mine level…so they have to skill up etc.
- GE have maintained engagement with off take. However, GE turbine division had a restructure. This hasn’t helped…..so a maybe….but have redundancy in place anyway.
Question - Shorting
Answer - CEO
- Monitoring. But it is difficult to know who is shorting ARU.
- Equity raises in the past….ARU gave a bias towards investors with a long term mandate.
- If look at the current shorting levels….quite low compared to others in the sectors.
- Best thing they can do is focus on FID…and construction.
Question - Gas Contract
Answer - CEO
- I missed part of this, but I think the 4th Feb was just a date extension to allow ARU/Gas suppliers to agree a CP extension date.
- Announcement on that new date very soon.
- However, Gas supply in NT is improving with time….means better longer term options…means cheaper.
- Risk around gas is reducing.
Question - Could new tech affect design of processing plant
Answer - CEO
- ARU have a Dr….who looks at new Tech
- Separation has some new tech…but rest of the processing doesn’t have any new tech.
- If new tech….would look at for phase 2. Needs to be proven.
Question - Update on Gina
Answer - CEO
- Hancock….they have been supportive. They are constantly updated and supportive of ARU funding strategy.

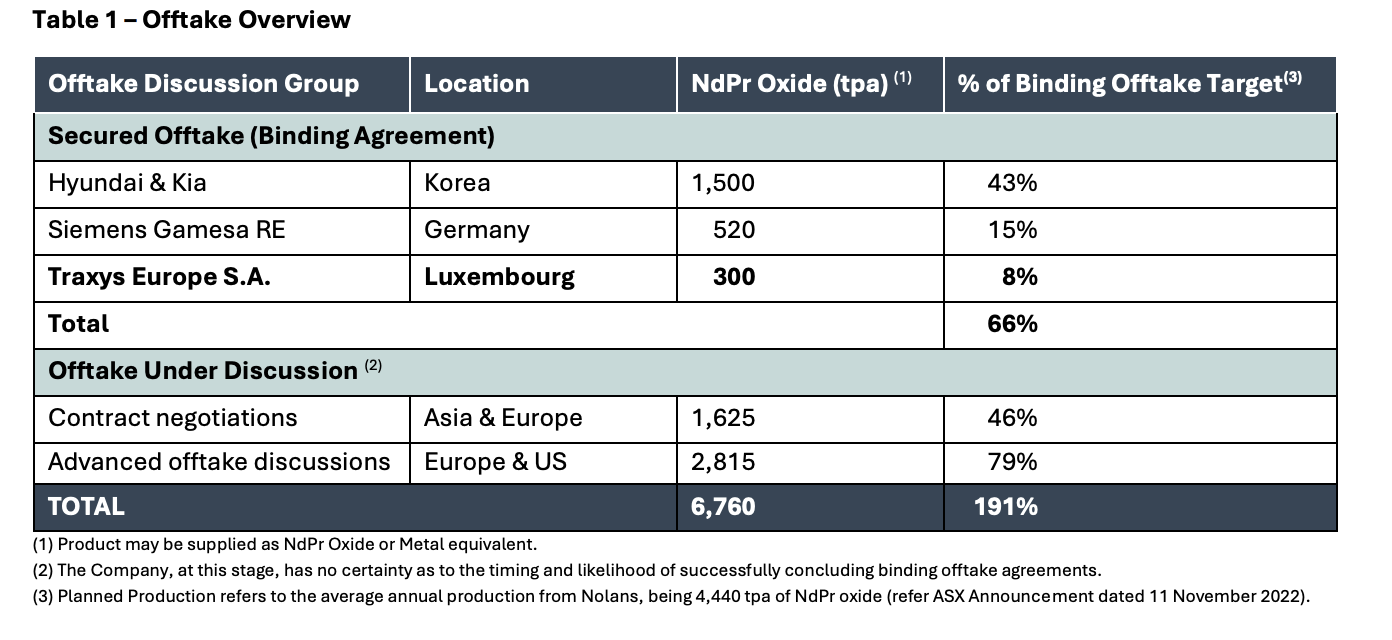

https://www.mining.com/web/arafura-rare-earths-gets-124-million-in-funding-from-australia/
Announcement to come today from Govt and on the ASX.
So ARU have convinced the Australian Govt through the Australian National Reconstruction Fund to invest AUS $200m as a convertbile note.
So the equity book build would look something like this:
Australian Govt. seems to be willing to do anything in this sector to get it moving. Look at the recent investment in ILU and other smaller investments.
I was recently a buyer in my super for more of ARU at 11 cents.

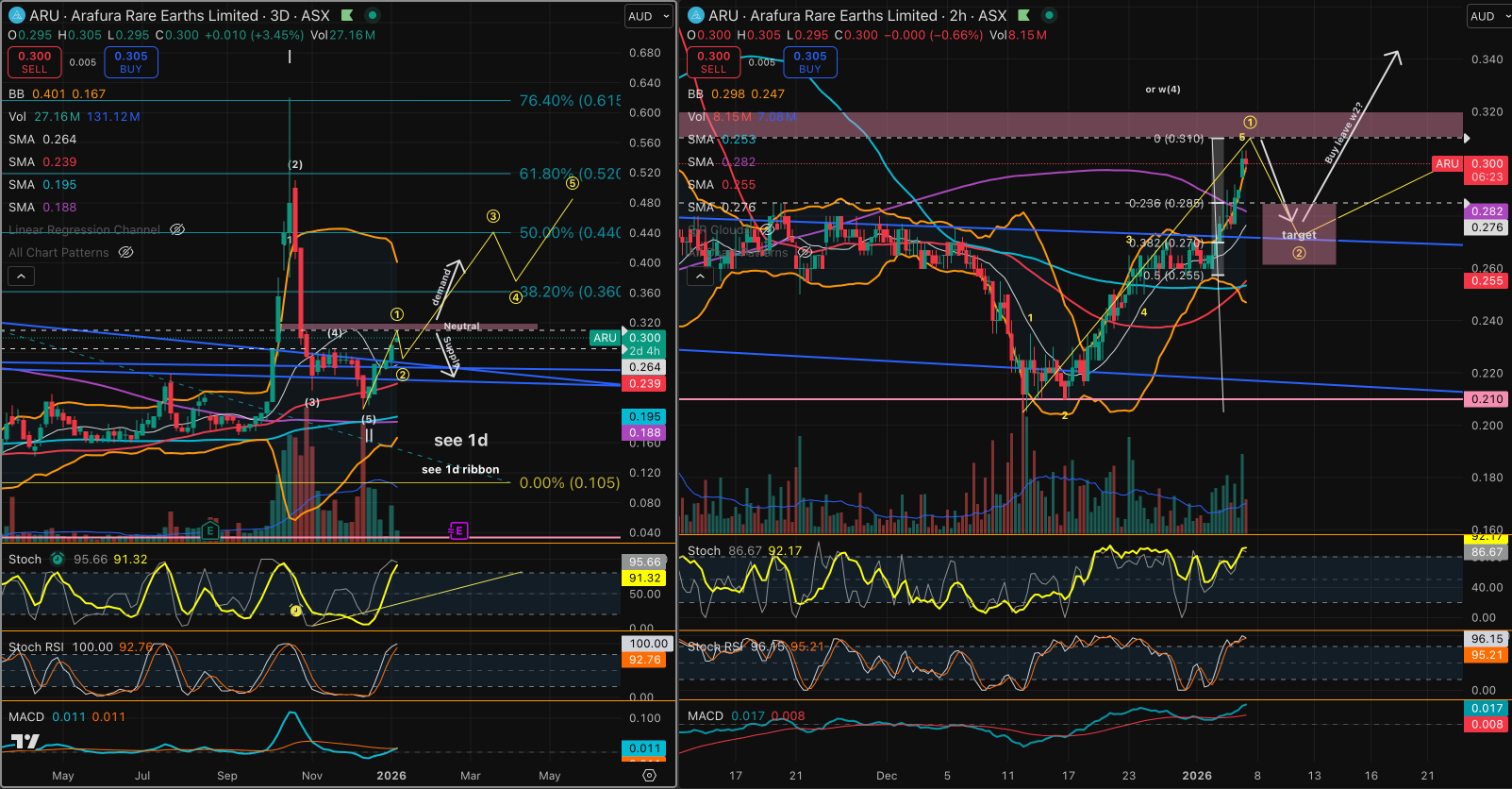

I expect the SP to move up today. But we have been heavily manipulated for months. So it should be interesting. I don't expect any short squeeze. They made their exit at the last Cap Raise (helped by our Chairman Mark S.....this guy is useless and I believe has links with some of our equity arrangers...likely Canncord).
The recent gas supply contract extentions were made to 4 Feb 2025. This is a strange date (given the annoucements were made in Decemeber 2024). This is what got me investing more last time they extended....so that date could be nothing.
But If I was the arranger...i would be getting Aust Govt to commit first....then cornerstone shortly after.....then a club of Funds....then annoucment of the SPP for retail. This could be all done in the next 2-3 months. More likely 6 months. But at each step the SP should increase (assuming no manipulation).
FYI - I have been heavily targeted by Chinese paid operatives/AI bots on hotcopper. They have even managed to get some others banned for a month or two for exposing them. HC does nothing (they like the traffic it brings). But it is clear what their agenda is. And just makes ARU even more likely to go ahead. The Aust Govt knows this....and will make it go ahead....and at almost any cost.
As Kim Beazely (former Labor leader) said....Aust is better to fund a few Rare Earth Mines...then buy/build a few frigates for the Navy. This is the best way to maintain our security for Aust and our allies.
Who is this from?
So the above statement was released by the Governments of the Republic of Korea (ROK) and Australia, Canada, Estonia, Finland, France, Germany, India, Italy, Japan, Norway, Sweden, the United Kingdom, the United States of America, and the European Commission following the conclusion of the Minerals Security Partnership Forum’s Principals’ Meeting in Brussels.
What did they say?
focused on advancing and accelerating MSP projects on rare earth elements, as well as identifying new responsible mining, processing, and recycling projects for critical minerals in MSP Forum member jurisdictions.
ARU explicity mentioned......
At the ROK-led MSP Project Deep Dive meeting, participants discussed the challenges to developing specific MSP projects, including HyProMag’s rare earth elements recycling project in the UK, Germany and the US, and the newly added Arafura Rare Earths’ Nolans Project in Australia, and identified means to advance these projects. Additionally, the Korea Institute of Geoscience and Mineral Resources (KIGAM) provided a briefing on its REEs recycling technology and ongoing projects.
My thoughts:
My hope is they have got some massive cash grant from the USA Dept of Defence.......
Standing back from it all. I still can't believe ARU has fallen to 11 cents. This project is going ahead. Too many Governments and their credit export agencies, and large teir 1 businesses have already committed. But i can't see any FID annoucment until mid Feb when all the parties boards/credit committees are back from holidays etc.
I'm probably going to load up another 20% of my holding in Late Janurary 2025.
Also note - that on H0tCopper, myself and some others have been targeted by a couple of downrampers. It has been pretty full on. They were using some type of AI to automatically generate negative responses and attack us...but when we f u cked with their algo....by inserting garbage text....they went quiet....for a few days...then have sprung back....with what feels like a real person now.
China has been using anything they can to get the west out of rare earths. Just look at all the games they are playing with Northern Minerals (ASX: NTU). Even after Treasury forced them to divest...they just create a new entity in Hong Kong....and almost were able to appoint a director onto th board. The Aust Govt just needs to step up.
There are 6 Resolutions to vote on in the upcoming ARU AGM.
Note the closing date for votes is 15 Oct 2024. The AGM will be held on the 17 Oct 2024.
Summary of my vote:
Resolution 1 – Remuneration Report To consider and, if thought fit, to pass the following as an ordinary resolution: “That for the purposes of section 250R(2) of the Corporations Act and for all other purposes, the Remuneration Report for the year ended 30 June 2024 be adopted.” Note: The vote on this Resolution is advisory only and does not bind the Directors or the Company.
My thoughts:
Resolution 2 – Election of Mr Michael Spreadborough as Director To consider and, if thought fit, to pass the following resolution as an ordinary resolution: “That Mr Michael Spreadborough, who was appointed by the Directors as an additional director during the year (and who holds office only until the conclusion of the Annual General Meeting in accordance with rule 7.1(c) of the Company’s Constitution), be elected as a Director of the Company with effect from the close of the Meeting.”
My thoughts:
Resolution 3 – Election of Dr Roger Higgins as Director To consider and, if thought fit, to pass the following resolution as an ordinary resolution: “That Dr Roger Higgins, who was appointed by the Directors as an additional director during the year (and who holds office only until the conclusion of the Annual General Meeting in accordance with rule 7.1(c) of the Company’s Constitution), be elected as a Director of the Company with effect from the close of the Meeting.”
My thoughts:
Resolution 4 – Election of Mr Ian Murray as Director To consider and, if thought fit, to pass the following resolution as an ordinary resolution: “That Mr Ian Murray, who was appointed by the Directors as an additional director during the year (and who holds office only until the conclusion of the Annual General Meeting in accordance with rule 7.1(c) of the Company’s Constitution), be elected as a Director of the Company with effect from the close of the Meeting.”
My thoughts:
Resolution 5 – Appointment of Auditor To consider and, if thought fit, to pass the following resolution as an ordinary resolution: “That, for the purposes of section 327B(1)(b) of the Corporations Act and for all other purposes, BDO Audit Pty Ltd, having been nominated by a Shareholder and having given its consent in writing to act in the capacity of auditor of the Company, be appointed as auditor of the Company with immediate effect.”
My thoughts:
Resolution 6 – Ratification of previous issue of securities under December 2023 Placement To consider and, if thought fit, to pass the following resolution as an ordinary resolution: “That, for the purposes of Listing Rule 7.4 and for all other purposes, Shareholders approve and ratify the issue of 156,250,000 Placement Shares and 78,125,000 free-attaching Placement Options to various sophisticated and institutional investors under the December 2023 Placement for the purposes and on the terms set out in the Explanatory Memorandum.”
My thoughts:
I hope that helps some people here.
Conclusion:
https://wcsecure.weblink.com.au/pdf/ARU/02842975.pdf
Just an MoU with Canadian company that has experience in extracting heavy rare earths...but interesting because Dysprosium (Dy) and Terbium (Tb) are some of the most sought after rare earths. Lets call them the rarest of rare earths? Haha.
Still lots of work to do in this space for ARU...so I would not factor this into my valuations, but if they can crack it, ARU could also be a heavy rare earth processor/supplier. I know LYC is working on this as well. But the ex China heavy rare earth supply is almost non-existant....so this would be very very valuable.
As always....these things take time...but this could be great for ARU.
https://wcsecure.weblink.com.au/pdf/ARU/02841373.pdf
Nothing really to note here.
But the Chairman and MD's reports at the start provides a great snap shot of why ARU will be a valuable company in the next few years. Def worth a read.
BTW - If I just happen to have found a mistake by the Auditor...what should I do? They have said they have audited the remuneration under Section 300A of the Corporations Act 2001. But they have not properly disclosed how the CEO's remuneration aligns with the company's financial outcomes.
For background the CEO was provided a dollar amount of options, which would be locked in at the SP at FID. So this means there is no incentive for him to maintain or increase the SP until after FID!!! How is that aligned to the current shareholders?
I'm back! Had alot of things on my plate (good things). And now I have a bit of free time again.
Alot has been going on with ARU.
First thing is the cap raise....very disappointing....and it has pushed the SP down to 16 cents. I imagine it will stay there until Sept when the raise is complete.
Second thing is the Final Cap Raise. The US $793 million. I met with the CEO a week ago and had provided questions beforehand. The meeting was a bit of complaints session from some retail holders which the CEO and CFO tried to deal with in a constructive manner. I had to jump in and talk about the future and what the Offer Price will be for the Final Cap Raise.
I told them that if they raise at 20 cents....that will erode all shareholder value in the short term. The CFO acknowledged this and said "the cornerstone equity investors can see past the current share prices". So that gave me some comfort that the raise will at least be above 20 cents. (i had originally thought the raise would be at about 40 cents...i'll explain why below).
I also asked if they had explored cash injetions from the Federal Australian Govt or the USA Dept of Defence? They didn't fill me with confidence. Kim Beezley has been saying that for global defence, the best way for the Govt to spend tax payer dollars...is to spend it on Rare Earths in Aust to help our global partners....rather than Aust. buying a new war ship etc. Here is the link:
He said $3-4 billion should be given to the Australian rare earth sector. He also said that China subsidies its rare earths and weaponises it by selling it below cost.
So....Right now....if they are to raise at 20 cents...this means a dilution of 74%.

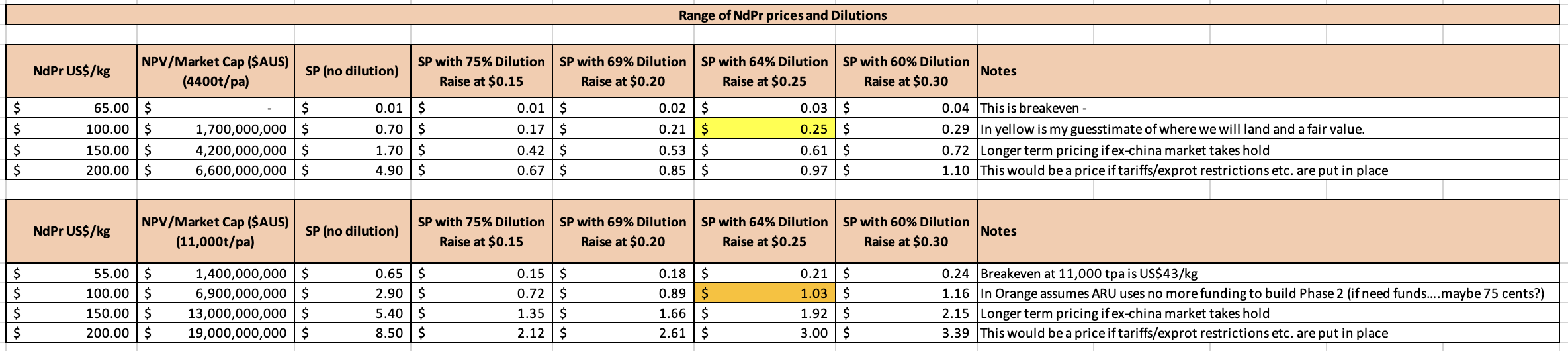

The following tables model the likely diluted SP for different NdPr prices.
First tabe is for the current design of the processing plant for 4,400 t/pa.
Second table if for the proposed processing plant with the additonal NdPr of 11,000 t/pa.
Ok....so as you can see....if they raise at 20 cents....the SP should stay at 20 cents. However, some points to note:
But I'm not real happy with the way this is likely to turn out in the short term.
My short term play for ARU will only just break even for me or a small profit upon FID. I have been trying to work out where it has gone wrong. The amount of equity and debt to be raised is WAY more than the capex. The cost to build is about US $1 billion.....and we will be raising about US 1.5 billion. That extra US $500 million is for cost overruns!!! So when I did my modelling....it was always on a much smaller project cost and thus a smaller debt/equity amount of finance. And thus a much smaller dilution...and thus a better dilluted SP for us.
I spoke to the CEO about this....and his reply was interesting. First he said they had learnt from Lynas, and wanted a large buffer so they don't have to go back to the market and it was something the debt providers wanted. I did say that they have had 20 years to get the design right for the processing plant and hundreds of millions spent refining the design and pilot plants. So maybe this is over kill? He then replied and said, the money not used in these contingencies (US $500 million) and the cash flows from Phase 1....will then be spent on Phase 2 which will take ARU from 4,400 to 11,000 tonnes per annum! And his message to the market is, don't wait for a 'Phase 2 Cap Raise'....
So what does this all mean?
Conclusion:
https://wcsecure.weblink.com.au/pdf/ARU/02832044.pdf
https://wcsecure.weblink.com.au/pdf/ARU/02832131.pdf
https://wcsecure.weblink.com.au/pdf/ARU/02832189.pdf
https://wcsecure.weblink.com.au/pdf/ARU/02832278.pdf
Just the Gas Supply contracts being updated and pushed out to reflect the likely timelines (ie construction to begin in 2025...operational in 2028 etc.)
Interesting how much of the NT supply is being used by ARU.
FYI - I am meeting with CEO on Wed. Should be an interesting meeting.
I have been doing alot of calculations...and my short term hopes have been dashed...but ARU remains a great medium/long term investment. I'll write more after Wednesday.
https://wcsecure.weblink.com.au/pdf/ARU/02830993.pdf
Sorry for the slow turnaround. Been swearing my head off. And trying to get answers from the CEO.
So this is NOT the big $800m cap raise.
This is the working cap raise for $27-30m at $0.16. SPP capped at $30k. $20m already raised by instiutions/funds. $7-10m from retail and the SPP.
So apparently....this is to give ARU runway 'past the final equity raise so that investors are not worried about ARU's funding when in negoitations'. So in other words....this gives us leveridge. But my question is....at what cost! Fark me. I'm so angry. Why do a SPP. Can't Aunty Gina just put in the full $30m? Or one of her mates? Why let the shorters get any of this.
So i am trying to get this all clear in my head. So i'm just going to write down a bunch of points:
Conclusion:
Thats it for now. Time to open a cheap bottle of wine.......
PS....as for my 'perfect timing for my trade yesterday'.....ha! totally jinxed myself.
So i'm hoping for no Retail SPP and they have locked all the equity from the instiutions/Gina/off take partners......
Glad i loaded up at 3:59pm yesterday! ha. Have i for once done the perfect trade?
Anyone who is interested...here is some background reading on ARU and the Rare Earth Market
https://www.arultd.com/products/our-products/
https://www.arultd.com/products/supply-and-demand/
https://www.arultd.com/investor/factsheets/
https://www.arultd.com/investor/presentations/
https://wcsecure.weblink.com.au/pdf/ARU/02597137.pdf
https://www.iea.org/reports/global-ev-outlook-2024/trends-in-electric-cars
https://www.iea.org/reports/global-critical-minerals-outlook-2024
https://peakrareearths.com/rare-earths/
https://sourcemagnets.com/control-cost-of-neodymium-magnets-for-product-development/
https://www.publish.csiro.au/ex/pdf/aseg2018abt4_3e
https://www.aspi.org.au/report/reclaiming-leadership-australia-and-global-critical-minerals-race
https://www.energy.gov/sites/default/files/2023-05/2023-critical-materials-assessment.pdf
https://physicsworld.com/a/powering-the-green-economy-the-quest-for-magnets-without-rare-earths/
https://www.customsmobile.com/rulings/docview?doc_id=NY%20N309996&highlight=8501.33%2A
https://www.mining.com/can-beaten-up-junior-miners-fight-illegal-short-selling/
Quarterly:
https://wcsecure.weblink.com.au/pdf/ARU/02830474.pdf
Debt and Phase 2:
https://wcsecure.weblink.com.au/pdf/ARU/02830241.pdf
Presentation:
https://wcsecure.weblink.com.au/pdf/ARU/02830242.pdf
Great news:
I listened to the webcast::
Anyway...i can't buy any more on Strawman...but I am buying in Real Life (RL). Time to load up! Back that truck up.....
Also there is this video from ARU CEO:
https://www.youtube.com/watch?v=28AC5oaHih8
https://wcsecure.weblink.com.au/pdf/ARU/02824445.pdf
ARU just announced another part of the debt pacakge. This was just the debt guarentee for the commercial loans. But another piece of the puzzle. So the last bit of debt to be locked in is the commercial package (ECA Covered Traches US$175m).
So what do we have to come:
Looking at the trading patterns....someone is still layering the buy and sell to keep the SP where it is. But I have noticed the short position has started to drop (we only have week old data).
Hoping soon...ARU will boom.
https://www.politico.eu/article/precious-rare-earth-metals-belong-to-the-state-china-declares/
So a few months ago China stopped the export of all Rare Earth technology etc.
And yesterday it upped the ante.....and mandated a bunch of regulations that gives the state total control.
There was a large illegal chinese rare earth industry. About 15% of global supply (from memory). But they have forced these to become legit...or turn them away.
China has been controlling the rare earth prices....but this gives them even more control.
So why would they want to do this now (some random thoughts)?
If we take a step back.....there is a clear directions here.......China sees Rare Earths as something it controls...and can use politically....and the west has woken up....governments are throwing money at it now.....but these projects take 10-15 years to come online (chemestry, approvals etc etc.).....and ARU are just 3-4 years away from production.....
Anyway....just some thoughts....what do others think?
Another Debt Annoucement
https://wcsecure.weblink.com.au/pdf/ARU/02823024.pdf
Another great accouncement. Almost all the debt secured. The Export-Import Bank of Korea (KEXIM) were always going to be the cork in the bottle. They came in late. So this is great news. I also know that the ARU team have been finalising the equity part in parallel with the Debt and Off take.
Also see the announcement last week that ARU director bought on market.
https://wcsecure.weblink.com.au/pdf/ARU/02819071.pdf
And other clue we are less than a month away from FID:
https://wcsecure.weblink.com.au/pdf/CTP/02817851.pdf
These guys are supplying gas to ARU onsite. This agreement was signed ages ago....but as part of that deal, ARU had to begin onsite by 30 June 2024. This annoucement gives a 1 month extension (so 31 July 2024) for ARU to begin onsite. So CTP would not extend for one month unless they were given assurances by ARU........
Summary:
So i pulled together this analysis.
Method:
Summary:
Additonally:
Have a listen to this:
https://www.abc.net.au/listen/programs/am/china-s-control-of-critical-minerals/103990098
Nothing new but this article just shows the critical mineral/rare earth investment theme(s) are now mainstream.
So I have been working on a model to see what the new US EV Tariffs and proposed Euro Tarriffs might do for NdPr demand.
And wow.
I'll put these slides here....and tmrw will put up my modelling approach. But I have got my exPwC friends to review. And they were amazed by the effects...and couldn't find any issues in my model.
https://wcsecure.weblink.com.au/pdf/ARU/02810642.pdf
Export Development Canada has provided US $300 million. Which brings the secured Debt to 68%.
Great news...and once again....selling walls put up to hold the SP in place by manipulators.
Some of my thoughts:
So i'm probably going to add to my holding. I can't do this on Strawman because of the % rules.
Even if retail do get to partake in a cap raise...it will be at higher prices than now.
It has been a while since I have tried to value ARU. I have rebuilt my NPV model for ARU given the new information to date.
Notes on my model:
- I have used information from the Definitive Feasibility Study (DFS) (7 February 2019) and updated for recent events.
- My model tries to broadly look at the cash flows for 23 years (mine life). It is quite a ‘coarse’ approach but the results are broadly in line with the results of the DFS which would have generated its results from a much more detailed model.
- I’m not a tax specialist, so I have tried to be conservative with the tax assumptions.
- I’m unsure how much Phosphoric Acid is to be sold (ie revenue) and how much is retained to offset the opex costs. This is not clear in the DFS. But even if I am wrong, it is only a small amount in the total revenue <5%.
- I have used a discount rate of 10%. I think this is quite conservative (especially given the Govt backing). But I have kept it at 10% which was also used in the DFS.
- For those of you running your own model, be very careful with currencies and units. Lots of data is provided in Chinese, USA and Aust. And different units like Kg, Tonnes etc.
- It does not factor in the dilution that will happen in the final equity raise.
Key points to note:
⁃ NdPr Pricing - The NdPr price obviously is key to the profitability of ARU and its corresponding Share Price. So to invest in ARU you need to take a view of the future of NdPr pricing. So I note the following on NdPr pricing:
o ARU will have lowest opex cost to produce NdPr. So it will have higher margins but also importantly, if the China tensions disappear (unlikely) it can ride out the troughs of NdPr pricing. Also, there is only so long China can sell NdPr at a loss. Or if they do, it will make western countries nervous. They are backing themselves into a corner with this price suppression strategy.
o ARU has locked in NdPr Pricing in its offtake agreements that are well above current spot market pricing. This means ARU will be profitable in the short term.
o NdPr demand is growing (even with the recent media saying it is not). And there are just no other NdPr projects coming online soon at scale. This will give monopoly type pricing power for ARU for its remaining 15% of supply. And if we can ramp up production, just adds to the profitability.
o The USA (and soon Euro) China tariffs will create large demand. These tariffs could be increased if Trump wins. This is a massive tailwind for NdPr pricing. I’m yet to estimate the impact of these policies. But I would expect it to be quite large. Again….this is NOT factored into my model’s assumptions.
⁃ Additional Revenue - ARU should be able to process other companies’ deposits (Minhub?). This is another revenue stream not factored into the model. We have asked ARU to clarify what it can do in this respect. Also, ARU have stated they will seek approval for Phase 2 for Nolans with much more NdPr below 200m. Either of these events will warrant a rerate of the SP.
⁃ Cost Overrun Risk - Much of the risk for a rare earth project is getting the processing plant working as designed. Lynas had massive issues in the early days. ARU has been on a 20-year journey. So there has been a lot of work done in this space. And the Cost Overrun Facilities provide a good-sized buffer should things not be quite right. So I think this risk has been managed quite well. But something to keep an eye on towards the end of construction and into the ramp up phase.
⁃ Processing Cost Rebate - The 10% government Processing Cost Rebate is great. But if it is removed by the Liberal Party, it will not have a massive impact on ARU.
The ARU Model:
Here is a screen shot of the inputs/outputs from my ARU model:
Conclusions:
- The modelled cashflows show a SP around $1.00-1.50 is realistic.
- NdPr pricing is likely to be strong given the current and prospective geopolitics and commitment of Governments to the energy transition.
- ARU has great potential for additional revenues (more NdPr onsite, additional processing of others, acquisitions).
- Senior management’s incentives aligned with shareholders.
- Strong environmental credentials.
Note - I will also post on Hotcopper.
I'm back from my honeymoon! So back to 'work'.
I thought it wouid be good to provide an update on ARU and what we know/have and what is coming up.
What we know/have as of 16 May 2024:
What is to come:
I have a question for the Strawman team - Are there any ASX listing rules about setting the Capital Rasie Offer Price ABOVE the current or recent share price? This would be good because there is less dilution. Also for the quick....could snap up some shares below the Offer Price. My quick read on the ASIC website says that for retail Share Purchase Plan (SPP) the Offer Price must be at a discount to the current SP. BUT for Insitutional Placement.....I think it can be set at any price? Can anyone confirm?
Conclusion:
Gina has been on a Lynas (LYC) buying spree. She how has 5.85%.
https://www.afr.com/companies/mining/rinehart-snares-big-stake-in-lynas-rare-earths-20240416-p5fkd4
She now has the following Rare Earth holdings:
- 10% Arafura (ASX ARU)
- 5.82% Lynas (ASX LYC)
- 5.3% MP Material in USA (NYSE MP)
- 5.85% Brazilian Rare Earths (ASX BRE)
It is clear Gina sees the potential in the rare earth sector. She also has the political influence in western parts of the world.
I just wonder what her playbook/strategy is?
- Leave them all separate
- Pros: Govt thinks there is lots of competition.
- Cons: Lots of management costs.
- Merge them all
- Pros: Saving on management costs, can control pricing (almost a monopoly in western world extraction and processing)
- Cons: Lots of scrutiny from Governments if looks and operates like a monopoly.
- Merge some
- Pros: Could get monopoly type prices without the scrutiny from Govt.
- Cons: Not as cost effective.
I’m just freestyling here…but I think a partial merger between them is good to extract monopoly pricing benefits, without pissing off Govt’s around the world.
So which ones would merge? There has been lots of talk between MP and Lynas. That would probably make sense. Would be able to build monopoly on prices, but keep ARU seperate to give appearance of there being a ‘market’. And then she could build ARU through acquisitions. The CEO of ARU told me this is ARU’s longer term plan to grow ARU (and that their Nolans deposit is much bigger).
Now the key question……how do we invest? I’m not sure how to do this type of analysis? How do people work out how to invest for potential mergers?
A lot been going on with ARU:
1 - Two new non-exec directors appointed:
https://wcsecure.weblink.com.au/pdf/ARU/02791328.pdf
Both have lots of mining experience. As expected. I have not done the digging on them yet. But reading between the lines, these appointments are probably a CP to one of the soon to be announced equity participants.
2 - New exec appointments
https://wcsecure.weblink.com.au/pdf/ARU/02794074.pdf
Dr Stuart Macnaughton commenced as Chief Operating Officer, Shaan Beccarelli commenced as Head of Corporate Affairs and Investor Relations and Tanya Perry was promoted to Head of Sustainability and Environment.
From what I have been told, the COO Stuart is a great hire. He will be onsite with his family in Alice Springs. And he is very aligned with shareholders given his remuneration package. Apparently it is hard to attract talent and compete on salary, so ARU has offered lots of share options. This type of remuneration will be across alot of the staff. And options set up in a way so that the staff have to back themselves. This is great for us as shareholders. Dilution for these will not be massive.
The other takeaway from this annoucement, is that these hires would not be happening unless there is certainity they project is going ahead.
3 - Funding package
The previous annoucement of Aust Govt funding was amazing. And not well understood by the market and not refledted in the SP. I understand that the debt particpants are many. And this has added to the compeltity of getting all parties signed up. I have worked on these types of deals....and delays happen all the time. Sometimes because some spanish banker has gone on holidays...and they need his approval etc.
I have previously been advised that equity discussions have been underway for some time. But I understand that the equity side is getting 'close'. Usually equity would not be 'close' unless debt is locked away. Ie equity want to see the compete funding package before commiting. So this is great news and gives me great comfort that the project will proceed to construction. And having the Aust Govt cost over run facility de-risks the construction and commisioning of the project. Remember that Lynas had massive issues commisioning their project.
4 - NdPr pricing
This seems to be on the way up. But it is controlled by China. And as previously mentioned, the western world wants ex-china supply (for certainity and for better ESG outcomes). There is lots of talk about countiries banning cars/products that have china supplied raw materials with terrible social and environmental effects. This will just add to the tail winds for ARU.
5 - Gina and MP Materials
Gina owns 10% of ARU and now 5% of MP Materials (a USA rare earth company). She also reportably owns alot of shares of Lynas (but she must own less than 5% because it is not reported). Lots of talk about Lynas and MP doing a merger.
My takeaway point is that Gina is setting herself up to be a powerhouse in rare earths. And she knows that Govertnments around the world will provide backing/incentives to build ex-china supply. Again a massive tail wind for ARU.
6 - Summary
Nothing has changed for me in my assessment of ARU. It will go ahead. And I think once all the finance has been announced we will see the SP go up quite a bit.
These Money of Mine guys have always hated ARU. I'd love to know why. They probably have mates who are short on ARU or have vested interests in other Rare Earth players?
https://www.youtube.com/watch?v=B96mQp0sFQE
To rebuff some of what they have said:
Anyway.....this is how to make money. You have to be contrarian....
And I hope to hold these Money of Mine guys to account in about 3-5 years when ARU is massive!

https://wcsecure.weblink.com.au/pdf/ARU/02784883.pdf
Still digesting the details.
But great result.
The headline figure is a bit decieving. A large chunk of the money is for Cost Overrun Facility Gaurentees (ie if the bank has to increase it's cost overrun facility...then the Export Credit Agency (in this case the Export Finance Australia and Northern Australia Infrastructure Facility) with provide increased guarentees. But the other side of it, means that if there are cost over runs....we have money! So this has de-risked it somewhat. But the way it is presented is confusing. I think Govt wanted to make the largest number possible...so just threw all the numbers into the annoucement. But I still need to fully understand what it means.
This is a quick table i knocked up.
The key thing i'm trying to work out is the size of the major capital raise to happen in a few months time.
If my understanding of the Cost overrun facility is correct....then they need to raise about $640 million (aussie). Which is about what we were told a month ago.
Approx 110 million shares are short for ARU. Approx 5%.
With the Aust Govt funding news coming out, debt funding to be annouced shortly, off takes to be announced and equity.....there is alot of positive news coming. Will be interesting to see if the shorts decided to exit the ARU Rocket Ship in the next few days?
Fingers crossed.
So this came out last night. We are still waiting for the ARU annoucement.
But in summary:
We were not expecting the $495 million.....This is epic! I assume that debt will stay the same size..and equity required is reduced meaning less dilution.
Lets see what today brings. But with lots of govt backing....ARU seems to be 99.9% going ahead!!!
ARU are in a trading halt. With an annoucement regarding "Debt Financing Support" to be released before Friday.
This should be good news and is in line with what I have previous said...Debt, then off take then final equity cap raise.
Also this was announced recently...and I'm hoping this is part of the offtake...finance package.
https://www.koreaherald.com/view.php?ud=20240312050533
"Posco International, the trading and energy arm of Korean steel giant Posco, announced Tuesday that it has recently secured a substantial order for rare earth permanent magnets, an essential part of an electric vehicle drive motor core, through its overseas subsidiaries."
"The permanent magnets secured by Posco International's overseas subsidiaries will not rely on rare earths from China, which accounts for over 90 percent of rare earths sourced globally, but will instead utilize raw materials obtained from the United States, Australia and Vietnam."
OK I'm back and married.
So mid last week I got the opportunity to meet online with the new CEO of ARU with around 10-12 others.
My notes are as follows:
My takeaway….I’m quite sure that ARU will get all the debt, off-take and equity and begin construction second half of this year. I think the change in CEO was always going to happen and is a good thing. I still think that ARU SP will move up and down until steady state production. So I will likely sell some after financial close…and then buy more closer to production/operational date. I’m also still considering buying more at this low price of about $0.12. There is a chance it may drop a little more if no debt annoucement by end of March.
Any questions…type a reply below.
Cheers
John
I’m super busy this week. So this will be short.
but yesterday ARU announced the long term CEO…Gavin is leaving. After 18 years. And they have a new experienced guy who has been in the ARU board for a little while. so he knows exactly what he is getting into.
normally when there is a change in CEO I would sell straight away.
but I think this is actually a positive.
gavin was the guy who got it to where we are today. But I think the finance parties would have wanted a delivery/operations leader.
in his contract his performance is linked to construction milestones and operational targets. So he would not have set those if he didn’t think finance is locked in.
i need to do some more research on him, so I can’t comment on him directly
also there has been no change in SP since this news
I think this is a positive for ARU to move forward
I’ll do some more research after my wedding this weekend!
The announcment is that ARU has got another US$75 million from the Korean Credit Export Agency (KEXIM).
With GE stalling on their offtake (due to their turbine division internal issues), ARU will be going to the other major players. ARU will def find another teir 1 off take player. This could change the funding mix. Ie if the other off take player is not german, then they may have to use their Export Credit Agency etc. This has def slowed their Financial Close. But I feel like they should be able to get there by March/April 2024 and with little dilution (ie only a small capital raise). I just hope they don't screw retail investors if they do go down the cap raise.
I have done some modelling of their business with a range of variables. But through all of the scenarios, I had always put in a larger capex (around $1.3 billion when they had about $1 billion in their Definitive Feasability Study.). The additional time lag has meant that inflation has absorbed some of that 'fat' i had put in. But I had also kept constant the operating costs of about $30/kg as opposed to their figure of $25/kg. Again i would assume some of that 'fat' will have been absorbed. I also assumed that it would take three years to be at a decent production (as opposed to their low 2 year figure). The NdPr prices have been steadily increasing again. But China is 100% manipulating the market prices. From the research I have done (and it's hard to get a definitive picture of how the Chinese operate their mines), the Chinese are selling at cost or a bit below cost. And that is at the current NdPr price of around US$60/kg. ARU's break even (at my inflated costs and timelines) will about US$55/kg and will be one of the cheapest rare earth producers AND do it with the best ESG credentials. With lots of companies now keen to spruik their ESG, I think this will make ARU's product highly sought after. And then there are the geopolitcal considerations that can only help ARU.
In summary the fundamentals of the project have not changed. GE stalling on their offtake obviously threw ARU's Financial Close off the timeline. I think we will hear some new off take announcment ealry next year (around mid Feb). And then hoepfully they can close this beast and start building!
I have looked back at how I could have invested in this stock better. And I feel that I entered about the right time except for two things that happened. The first was the chinese selling their stake in ARU on market. I has assumed that Gina or a big Insistution would have bought off market. So that constant selling gave the shorters and manipulators an opportunity. The second part i got wrong was that GE would fall away as an off taker. This has added 6 months to the timeline.
Anyway, good learning.
Parko
PS it is a bit of a ramble....but if anyone is interested, i can present more detail on any of the above or other issues regarding ARU or Energy Transition etc.
This is my first post on Strawman. So please let me know if I have not followed the right process or proforma etc. And please let me know your thoughts on any of the points below. This is just a quick summary of a longer report I wrote for myself a couple of months ago with more graphics from different sources etc.
ARU’s Definitive Feasibility Study (DFS) used the following assumptions:
They get an NPV of A $729 million which would equate to a SP of about $0.30 - $0.40. Current SP is about $0.25. Breakeven would mean the NdPr price is around US $55 /kg.
However, if you look at the following NdPr prices and corresponding NPV/SP you can see how sensitive it is (note all approx.).
So we need to look at the long term pricing of NdPr.
Some factors at play:
So the current NdPr price of around US $80/kg could be considered low.
Since Strawman asks for a valuation, I believe that in the near term (ie next six month or when Financial Investment Decision/Finance is achieved) ARU should be valued at about $0.70 – 0.90. I think during construction the market will probably get bored…and then the SP could fade. Also there is the risk of cost overruns or delays. So that may also cause downward pressure on the SP. But once production begins and ARU is ramped up….I believe that a SP of around $1.20 is realistic. This would be around 2027.
Conclusion:
Cheers
Parko
Price sensitive:
The trend - should we invest?
A look at the resource:
Neodymium is the strongest permanent magnet material yet discovered. It is widely used in microphones, professional loudspeakers, headphones, computer hard disks, electric motors and generators. It is a rare-earth mineral mostly extracted in China, the United States, Brazil, India, Sri Lanka, and Australia.
Pending offtake agreement
So await an announcement. Could be after Easter next Tuesday
Georgia H Rhinehart, Hancock Prospecting...scoops up 8.37% voting power
'Bang' closed 52.5cps up 18%
MINERAL SANDS AND RARE EARTHS CONFERENCE 22 November 2022 Arafura Rare Earths Limited | ABN: 22 080 933 455 Level 6, 432 Murray St, Perth WA 6000 PO Box 5773, St Georges Terrace, Perth WA 6831 T: +61 8 6370 2800 | W: www.arultd.com | E: arafura@arultd.com Arafura Rare Earths Limited (ASX: ARU) (“Arafura” or the “Company”) is pleased to attach a copy of its presentation delivered by Managing Director, Gavin Lockyer, at the 23rd Annual Mineral Sands and Rare Earths Conference held in Perth on 22- 23 November 2022
ARU team advancing this agreement with Hyundai to achieve the jointly held goal of executing a definitive binding offtake agreement by September 2022.
2924-02569932-6A1110283 (markitdigital.com)
Enjoy
Placement at: 0.265cps
So could some price depreciation while the Placement proceeds.
trades today at 0.32cps
Could be an opportunity ..who knows..
